REVIEW article

Front. Sustain. Cities, 10 February 2026

Sec. Sustainable Infrastructure

Volume 8 - 2026 | https://doi.org/10.3389/frsc.2026.1760070

Toward better social value creation in road infrastructure: a conceptual model

  • Laboratory of Construction Management, Department of Civil Engineering, Institut Teknologi Sepuluh Nopember, Surabaya, East Java, Indonesia

Article metrics

View details

587

Views

40

Downloads

Abstract

Project social value has emerged as a critical dimension of sustainable road infrastructure, aligning with the United Nations Sustainable Development Goals (SDGs). However, limited integrative models explain how project social value can be systematically embedded in infrastructure delivery. This study develops a conceptual model to enhance project social value in road construction through a comprehensive synthesis of prior research. The model identifies five factors: community engagement, government role, sustainability practices, organizational performance, and design, represented by 38 indicators. Grounded in stakeholder and sustainability theories, the model positions project processes as the dynamic context through which these determinants interact to generate social outcomes. The study advances theoretical understanding by integrating social and technical dimension of sustainability, and provide practical guidance for policy makers, managers, and practitioners to embed social value principle within infrastructure planning and delivery.

1 Introduction

Infrastructure projects, particularly road construction, significantly influence a nation’s economic development by enhancing accessibility, mitigating inequality, and fostering local economic advancement (Khan et al., 2021; Chan et al., 2022). Road construction projects not only serve to improve connectivity and facilitate mobility, but can also have other positive effects, such as opening access to remote areas, creating jobs, and improving the quality of life of the community. Considering that road construction projects immediately engage with and affect adjacent communities, it ought to be conceived and executed to provide significant social value. This involves meeting the project’s technical specifications while simultaneously guaranteeing that the results enhance social welfare, empower communities, and provide equitable access to opportunities.

Social value in infrastructure development refers to the supplementary social, economic, and environmental advantages produced by a project beyond its core functional objective (Raiden and King, 2021). The social value of a project encompasses its conclusion, along with the anticipated long-term benefits and impacts for stakeholders and the broader community (Cartigny and Lord, 2017; Gidigah et al., 2022). This social value is crucial and can significantly impact a project’s success or failure (Chipulu et al., 2014). Integrating social values into construction projects is crucial to ensure that the benefits of development are not limited to a small group of people or specific parties but are enjoyed by the entire community, including vulnerable groups. A project’s social value has become an indicator of construction project success, reflecting a recent shift in the paradigm (Gyadu-Asiedu et al., 2024; Ika and Pinto, 2022).

Traditionally, construction projects have focused on achieving the triple constraints of time, cost, and quality. Project managers tend to focus their efforts on controlling costs within budget, ensuring timely completion, and achieving desired quality standards. These three aspects form the primary basis for decision-making, planning, and implementation of construction projects (Van Wyngaard et al., 2012). However, a paradigm shift has occurred whereby the success of a project is measured not only by these three constraints but also by the social value the project creates for the community. Road projects should not be judged solely on technical and financial metrics but also on their ability to create meaningful and sustainable social value. This paradigm shift, reflected in the integration of social, environmental, and economic considerations, is often referred to as the triple bottom line (Elkington and Rowlands, 1999), has positioned social value as a crucial measure of project success, particularly for publicly funded infrastructure that directly impacts communities. This shift in perspective emphasises the necessity of success indicators that go beyond conventional financial and technical measurements. From this perspective, integrating social value into road construction projects is not only a managerial concern but also a strategic mechanism for operationalising the SDGs at the project level.

Despite the increasing alignment between infrastructure development, social value, and the SDGs, existing research in construction and infrastructure management remains fragmented. Prior studies have often examined through isolated lenses such as community engagement, sustainability practices, or at a single project stage, without offering an integrated conceptual framework specifically tailored to road construction projects. As a result, there is a limited systematic understanding of how these diverse elements collectively contribute to social value creation and SDG achievement in road infrastructure development.

To address this gap, this study adopts a narrative review approach to synthesise existing literature on social value in road construction projects. By integrating insights from multiple theoretical perspectives and develops a coherent conceptual framework. The proposed framework aims to support both researchers and practitioners in better understanding, assessing, and embedding social value in road construction projects, while also contributing to the practical implementation of the SDGs within the infrastructure sector.

2 Theoretical background

2.1 Social value in construction

The social value of a project is its functional utility for life and shared goals, so it is neither absolute nor relative (Choi, 2014). A project’s social value must be viewed as “worth” because it encompasses the project’s outputs and outcomes (Martinsuo et al., 2019). The concept of “social value” in construction projects refers to the potential benefits a project can offer to local communities and the wider community. These benefits can be both long-term and short-term, ranging from employment or housing to public facilities and sustainability.

Social value in the construction industry encompasses the additional benefits that contribute to community well-being, social inclusion, and sustainable development (

Raidén et al., 2019

). In road projects, these benefits can include reduced transport inequality, improved access to essential services, job creation, and skills development for local populations. The construction industry, particularly projects, has unique characteristics compared to the manufacturing industry. Projects with a high degree of variability and change in design, location, production environment, and supply chain structure are used to carry out their task (

Raiden et al., 2018

).

Raiden et al. (2018)

also state that each project offers different social value, which depends on several factors, including:

  • Project size. Larger projects typically could offer more social value than smaller projects.

  • Project type. Economic infrastructure, such as roads and railways, offers significant social value opportunities due to the large number of communities they impact. Social infrastructure (schools, hospitals, etc.) offers social value based on the nature of its operations, for example, in education and healthcare. Housing provides other forms of social value related to security, comfort, a sense of home, family cohesion, and wealth creation.

  • The project’s location. Because there are more community needs and chances to hire underprivileged local communities, projects in low-socioeconomic areas usually have a larger social value proposition.

  • Innovative project design, urban design, and buildings promote safe and healthy living and generate economic value by attracting new businesses to an area. Materials specified in the design can be sourced from responsible suppliers, creating social value in their production, and the construction technologies implied by the design can create or destroy job opportunities.

  • Integrated procurement helps reduce the focus on short-term gains and encourages more sustainable solutions, like energy-efficient technologies that lower overall costs. It also allows more people involved, like building users and the community, to work together. Integrated procurement also offers more opportunities for stakeholders (such as creating users and the community) to share and collaborate on project outcomes.

  • Local supply chains: The use of local businesses and social enterprises in a project’s supply chain can create employment and business opportunities for local and disadvantaged groups.

  • Timing (the political, social, and economic context in which a project is constructed): By preserving jobs, projects constructed during a recession can add greater social benefit. There are more incentives and chances to add social value to the project if the government is politically willing to take social value into account throughout the bidding process.

The concept of ‘social value’ in construction projects refers to the potential benefits a project can offer to local communities and society. These benefits can be long-term and short-term, ranging from employment or housing to public facilities and sustainability. The social value of a project must be seen as “worth” because it is in the form of project output and outcomes resulting from the project (Vuorinen and Martinsuo, 2019). In practice, social value in construction projects is influenced by legislation, procurement, and increasing public demand for CSR (Raiden et al., 2018).

According to

Martin (1997)

and

Green and Sergeeva (2019)

several criteria can be used to evaluate whether a project has succeeded in creating social value. These criteria include:

  • Achievement of social objectives. This criterion covers the extent to which the project achieves its stated social goals, such as improving the quality of life, reducing poverty, or creating jobs.

  • Increased Economic Benefits. This criterion covers the economic benefits generated by the project for owners, managers, and the community at large.

  • Equity and Inclusion. This criterion covers the extent to which the project addresses social justice and inclusion, including how it benefits marginalised or vulnerable groups.

  • Capacity Development. This criterion encompasses the capacity building of individuals or communities involved in the project, including the acquisition of increased skills, knowledge, and the ability to participate in decision-making processes.

  • Stakeholder Perception and Satisfaction. This criterion covers how well the project meets their expectations and needs.

  • Long-Term Impact. This criterion covers the sustainable positive changes in social, economic, and environmental conditions resulting from the project.

  • Social Innovation: This criterion includes the extent to which the project creates innovative solutions to existing social problems, as well as the ability to inspire other projects or broader policies.

2.2 Relevant theoretical perspectives

2.2.1 Stakeholder theory

Stakeholder theory was initially proposed by Freeman (1984), who asserted that organisations bear responsibility not solely to shareholders but also to all entities with a vested interest in the organisation’s operations. Parmar et al. (2010) assert that stakeholder theory has developed into normative and instrumental frameworks. This idea underscores the significance of honouring the interests of each stakeholder as an intrinsic value. This approach is viewed as a method to enhance organisational performance by augmenting legitimacy, trust, and stakeholder support. In construction projects, stakeholders can be diverse, encompassing a range of entities, including project owners and contractors, government agencies, and the surrounding community. Identifying stakeholders early in a project is important in guaranteeing its success. It’s crucial to analyse the level of interest, expectations, concerns, and influence of each stakeholder.

Furthermore, a bibliometric review by Mahajan et al. (2023) confirms the rapid growth of this research since 2000. From 988 articles (1969–2021), they identified four main clusters: stakeholder theory and sustainability, stakeholder theory and organisational performance, stakeholder theory and strategic management, and stakeholder theory and stakeholder management. This mapping demonstrates that stakeholder theory is relevant not only to business but also to the public sector and infrastructure projects.

The implementation of Stakeholder Theory is essential in infrastructure projects, especially road projects, as they directly engage with the broader community, governmental entities, contractors, and the business sector. The normative approach underscores the ethical duty to guarantee that the project provides equal social benefit to impacted communities, but the instrumental perspective asserts that technical success (cost, quality, time) will be more sustainable if stakeholder interests are duly considered. Consequently, Stakeholder Theory can provide a robust theoretical framework to elucidate why the generation of social value ought to be a principal aim in road construction.

Although Stakeholder Theory has been recognised as a relevant conceptual framework for explaining stakeholder involvement in projects, its implementation in project management practice still faces various obstacles. The results of the study by Wojewnik-Filipkowska et al. (2019) show that the complexity of relationships between stakeholders, limited communication, and conflicts of interest often hinder the practical application of this theory in real projects. In the context of construction projects, project managers tend to focus more on achieving the iron triangle (cost, quality, and time). At the same time, the aspect of creating social value is often placed as a secondary priority.

2.2.2 Sustainability theory

The concept of sustainability, popularised by the World Commission on Environment and Development (1987), emphasises development that meets the needs of the present without compromising the ability of future generations to meet their own needs (Rivai and Rohman, 2020; Srivastava et al., 2021). Sustainability is generally conceptualised through three interdependent pillars: economic, environmental, and social, which is known as the triple bottom line (Silvius and Schipper, 2014). While economic and environmental aspects have received significant attention in infrastructure projects, the social dimension often remains underexplored despite its crucial role in ensuring the long-term well-being of society (Hidayat et al., 2020; Rivai and Rohman, 2020; Wang et al., 2018). To achieve optimal social sustainability in development, it is crucial to integrate social values into every construction project. By considering the social impacts they generate, construction projects can meet economic and environmental goals and provide tangible benefits to the broader well-being of society.

In relation to stakeholder theory, sustainability theory extends the discussion from identifying who is affected by a project to evaluating how the project outcomes affect them. This aligns with the necessity of embedding social sustainability within road construction projects, ensuring that infrastructure not only functions as a physical asset but also as a catalyst for inclusive and equitable development. The integration of sustainability theory also aligns with global development agendas, particularly the Sustainable Development Goals (Lee et al., 2016), especially SDG 9 on resilient infrastructure and SDG 11 on sustainable communities. Well-designed roads can enhance mobility, facilitate access to education and health care, and stimulate local economies, thereby supporting both economic and social objectives (Acheampong and Silva, 2015; Hidayat et al., 2020).

3 Methodological approach

This study adopts a narrative review approach to examine the integration of social value within road construction projects. This approach allows for greater flexibility in synthesising diverse theoretical perspectives and conceptual debates, which is particularly appropriate given the exploratory aim of the study to develop a theoretical model that explains the factors influencing social value creation in infrastructure projects, especially road projects.

The literature analysis primarily focused on peer-reviewed journal articles to ensure conceptual robustness and academic rigour. Conference papers and academic books were used selectively to complement theoretical discussion, while theses and dissertations were consulted only during the initial scoping stage to contextualise the research domain, rather than serving as primary sources for factor or indicator derivation.

The analysis process followed a structured conceptual synthesis strategy. First, relevant literature addressing social value, stakeholder theory, sustainability, and road infrastructure development was screened. Key concepts, themes, and social value-related indicators were then systematically extracted from the selected studies and compiled into an initial pool of indicators.

Subsequently, a synthesis and clustering process was undertaken to group conceptually similar indicators based on theoretical affinity and thematic relevance. Through this process, indicators were organised into five higher-order factors representing the main dimensions influencing social value creation in road construction projects.

Finally, the resulting factor-indicator structure was reviewed to ensure internal consistency, conceptual clarity, and relevance to road infrastructure projects. The outcome of this process is a conceptual model for optimizing project social value in road construction projects.

4 Factors influencing social value in road construction projects

Social value in construction extends beyond the physical completion of a project, encompassing long-term benefits such as improved quality of life, public facilities, and employment opportunities that ensure lasting positive impacts for future generations. It has become a crucial dimension of project success, reflecting an organisation’s commitment to social responsibility and community well-being. In road construction projects, social value is particularly significant due to their direct, prolonged, and spatially embedded interactions with local communities, users, and surrounding environments. Projects that embed social principles from the outset can foster trust, minimise conflict, and enhance corporate reputation, transforming social value into a strategic investment rather than a mere obligation.

Building on the synthesis of the reviewed literature, this study identifies and classifies the key factors influencing the achievement of social value in road construction projects. Through a structured factor synthesis process, five interrelated determinants supported by a total of 38 indicators were derived and are summarised in Table 1. These factors represent higher-order dimensions emerging from recurring themes in the literature and reflect both governance-related and practice-oriented perspectives on social value creation.

Table 1

Influencing factors Indicators Source
Community engagement Level of community participation Watts et al. (2019), Lawer (2019), Ng et al. (2013), Erkul et al. (2016), Mirzakhani et al. (2023), Fujiwara et al. (2021)
Level of community satisfaction Watts et al. (2019), Liu et al. (2019), Lawer (2019)
Level of community understanding Liu et al. (2019), Lawer (2019), Erkul et al. (2016)
Level of communication Liu et al. (2019), Ng et al. (2013), Lawer (2019)
Level of transparency Liu et al. (2019), Lawer (2019)
Level of responsiveness Liu et al. (2019), Ng et al. (2013), Lawer (2019)
Level of support Watts et al. (2019), Liu et al. (2019)
Government role Guarantee of social, economic, and political conditions Ng et al. (2013), Damoah and Kumi (2018)
Regulations and Policies Ng et al. (2013), Rohman and Wiguna (2021)
Financial guarantee Cartigny and Lord (2017), Krannich and Reiser (2021), Liu et al. (2019), Raiden et al. (2018)
Procurement Gidigah et al. (2022), Raiden et al. (2018)
Land acquisition and compensation Ghimire et al. (2017), Huang and Yeh (2008)
Project sustainability practices Efficient resource management Agyekum et al. (2021), Bamgbade et al. (2019), Huang and Yeh (2008), Maelissa et al. (2023)
Water and air quality Liu et al. (2019), Krannich and Reiser (2021)
Carbon footprint Krannich and Reiser (2021), Liu et al. (2019)
Level of social justice Liu et al. (2019), Krannich and Reiser (2021)
Level of community empowerment Liu et al. (2019), Krannich and Reiser (2021), Ng et al. (2013)
Quality of life Abdel-Raheem and Ramsbottom (2016), Mirzakhani et al. (2023), Cartigny and Lord (2017), Rohman et al. (2017)
Waste management Huang and Yeh (2008), Abdel-Raheem and Ramsbottom (2016), Yuan (2012)
Use of environmentally friendly materials Liu et al. (2019), Krannich and Reiser (2021), Abdel-Raheem and Ramsbottom (2016)
Environmental restoration Liu et al. (2019), Krannich and Reiser (2021)
Project organizational performance Level of compliance with regulations and standards Liu et al. (2019), Krannich and Reiser (2021)
Organizational commitment to achieving sustainability goals Liu et al. (2019), Krannich and Reiser (2021), Abdel-Raheem and Ramsbottom (2016)
Organizational performance in achieving project goals Silvius and Schipper (2014), Abdel-Raheem and Ramsbottom (2016)
Risk management Silvius and Schipper (2014), Fujiwara et al. (2021)
Social impact analysis (Cartigny and Lord (2017), Raiden et al. (2018), Watts et al. (2019))
Measurement and evaluation Fujiwara et al. (2021), Kerzner (2016)
CSR implementation Liao et al. (2017), Vuorinen and Martinsuo (2019)
Level of collaboration and partnership Lawer (2019), Ng et al. (2013), Liu et al. (2019)
Design Suitability of design to user needs Watts et al. (2019), Raidén et al. (2019), Rohman et al. (2017)
Inclusiveness and accessibility Watts et al. (2019), Hidayat et al. (2020), Mirzakhani et al. (2023), Fujiwara et al. (2021)
Safety and health Watts et al. (2019), Raidén et al. (2019)
Social interaction Watts et al. (2019), Chan and Lee (2008)
Local identity and culture Watts et al. (2021), Rohman and Wiguna (2021)
Aesthetics Rohman and Wiguna (2021), Hill and Bowen (1997)
Pavement quality Kazancoglu et al. (2021), Zheng et al. (2020), Kothari et al. (2022)
Drainage and rainwater management Huang and Yeh (2008), Zheng et al. (2020), Kazancoglu et al. (2021)
Road capacity Huang and Yeh (2008), Zheng et al. (2020), Kazancoglu et al. (2021)

Factors influencing social value in road construction projects.

According to Table 1 above, five main factors were identified that influence the achievement of project social value in road construction projects. These five factors are: community involvement, government role, project sustainability practices, project organisational performance, and design. Community engagement is central, as projects that actively involve communities are more likely to generate ownership, trust, and long-term social benefits (Dare et al., 2014). This finding is consistent with the social sustainability literature, which emphasises participatory processes as a foundation for inclusive and socially responsive infrastructure development.

The government’s role is equally significant, since the policy frameworks, regulations, and financial mechanisms determine the enabling environment for project social value (Albareda et al., 2007). Moreover, project sustainability practices ensure that infrastructure development balances environmental responsibility with social justice, while organisational performance influences how effectively stakeholders’ expectations are translated into tangible outcomes. Design, as the last factor, directly affects inclusiveness, safety, and cultural identity, thereby shaping the everyday experience of communities that use and live around road infrastructure (Rohman and Wiguna, 2021).

Taken together, these five factors provide an integrated conceptual lens for understanding how social value is created, embedded, and sustained throughout the lifecycle of road construction projects. The importance of governance, public involvement, and institutional capacity as key facilitators of social sustainability outcomes is also highlighted in recent research on smart and sustainable cities (Kumar et al., 2025).

5 Toward a conceptual model

The synthesis of influencing factors indicates that social value in road construction projects is not the outcome of a single dimension but rather the result of dynamic interactions among multiple categories. Drawing on stakeholder theory and sustainability principles, this study identifies five key determinants: community engagement, government role, sustainability practices, organisational performance, and design. Each factor represents a distinct yet complementary dimension. Community engagement highlights the alignment of project outcomes with local needs and legitimacy, while the government’s role emphasizes regulatory and institutional support. Sustainability practices underscore the integration of environmental and social responsibility, organizational performance reflects managerial and institutional capacity, and design captures inclusiveness and functionality for end users. Together, these determinants provide the foundation for understanding how social value can be achieved in infrastructure delivery, especially road infrastructure.

Based on this synthesis, a conceptual framework is proposed in Figure 1. The framework positions project processes (dashed-line box) as the context in which the five determinants: community engagement, government role, project sustainability practices, organizational performance and design emerge and exert their influence. The dashed line boundary denotes the project process domain, emphasizing that these determinants manifest and interact throughout project delivery rather than acting as isolated variables. The arrows indicate directional influence toward the project’s social value outcome (oval), clarifying how value is co-produced through the inclusion, government support, sustainability integration, organizational capability, and design. The indicators derived from the literature for each factor are presented in Table 1, while the detailed elaboration of how these factors influence project social value is provided in the discussion section.

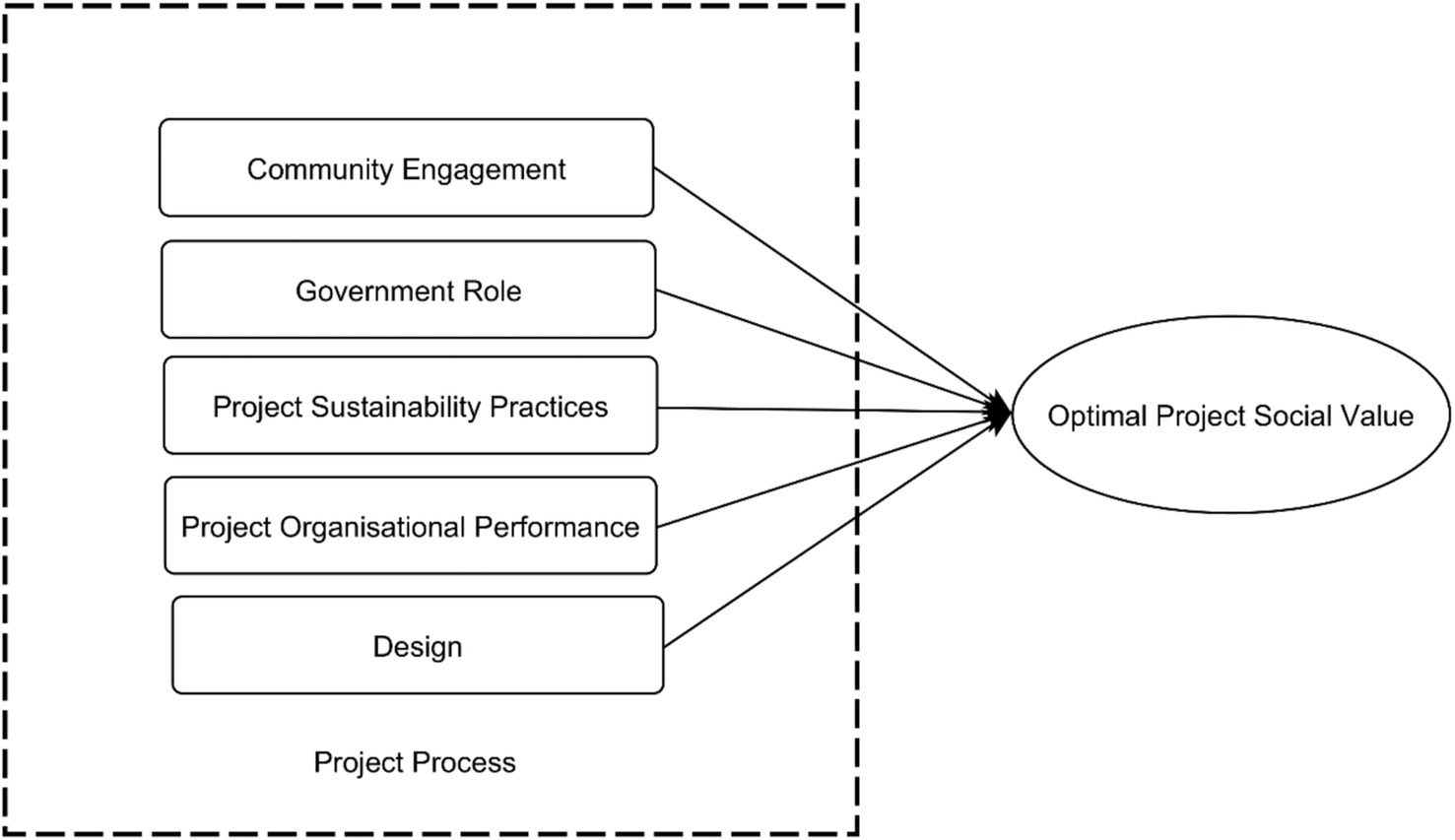

Figure 1

Diagram showing five factors—community engagement, government role, project sustainability practices, project organisational performance, and design—grouped under project process, each pointing to optimal project social value.

A conceptual model to optimise project social value.

6 Discussion

Building on the proposed conceptual model, this section elaborates on how each determinant contributes to the achievement of project social value in road construction projects. The relative importance of these factors and their indicators may vary across different project stages. For instance, community involvement is crucial during the planning and design stages but becomes less important during the implementation stage. Meanwhile, organisational performance and sustainability practices are essential during the implementation stage but become less important during the operational stage. This dynamic variation reflects the project process domain in the conceptual model, which illustrates that the determinants emerge and interact across different phases of project delivery. Therefore, a factor synthesis process is necessary to determine which factors and indicators are most influential in shaping project social value.

Community engagement is the first factor that influences the achievement of the project’s social value. Engaging communities in project planning and execution increases the likelihood of tailoring the project to align with local requirements, expectations, and values. This ensures that the project provides direct benefits to affected communities. Community involvement can increase support and acceptance of the project, reducing the risk of resistance or social conflict (Conde and Le Billon, 2017). Engaging the community can help identify potential social risks and adverse impacts early in the project lifecycle (Haddaway et al., 2017). Mechanistically, meaningful participation and transparent, responsive communication foster perceived fairness and shared ownership, while an accessible grievance redress channel converts potential disputes into collaborative problem solving, thereby safeguarding long-term community benefits (Yang et al., 2009). In archipelagic road contexts, where access, livelihoods, and land issues are sensitive, these mechanisms are decisive. This proactive approach enables the development of mitigation plans, ensuring that the project will contribute positively to the community rather than unintentionally harming it. Effective community participation raises the probability that a project will endure over time. Community engagement emerges as a central driver of social value in infrastructure projects, yet its effectiveness depends on the quality of interaction rather than the mere existence of participation. Similar findings are reported in the social infrastructure literature, which highlights that participation is most impactful when it fosters inclusiveness, accountability and collaborative governance (Mashabela et al., 2025). Leung and Yu (2014) demonstrate that structured approaches such as Value Methodology (VM) can provide a logical and neutral framework for dialogue, transforming destructive conflict into constructive outcomes that strengthen trust, team spirit, and organisational reputation.

The government is essential in several areas, including capacity building, long-term strategic goal formulation, community involvement, financial support, partnerships, and regulatory framework (Ofori, 2015). When taken as a whole, these steps improve a project’s potential to produce significant social value and support sustainable development. The rules and guidelines that direct the creation and execution of projects are set by and enforced by governments. These laws have the power to require specific social and environmental factors, guaranteeing that projects make a beneficial contribution to sustainability and societal well-being. The government can provide grants, loans, and other forms of financial aid to construction projects that aim to generate social benefits.

Sustainability practices play a pivotal role in determining the extent to which road infrastructure contributes to long-term social value. Sustainability in construction projects is often linked to the creation of healthier and safer living environments, which directly improves the quality of life of local communities. Sustainability practices aim to minimise the negative impacts of construction projects on the environment (Yusof et al., 2017). Embedding sustainability into project practices, such as minimising carbon emissions, effective waste management, and ensuring social justice, can enhance both the perceived legitimacy and tangible benefits of infrastructure. According to Kaur and Pandey (2021) Sustainable road projects must adopt practices such as the use of low-emission construction technologies, environmentally friendly materials, and effective dust and pollution control strategies. These measures not only mitigate the ecological footprint of infrastructure projects but also contribute directly to improving local air quality and community well-being. Road projects can make a tangible contribution to global goals, such as SDG 11 (Sustainable Cities and Communities) and SDG 13 (Climate Action), by integrating sustainability practices with the mitigation of climate change and its associated public health implications. By establishing environmental management as essential to the legitimacy and acceptance of infrastructure development, this highlights the role of sustainability as a catalyst for creating social value.

Project organisational performance is crucial to achieving social value because it encompasses how well an organisation manages and executes its projects. High organisational performance ensures the effective management of resources, including staff, money, and time (Kerzner, 2016). The findings of Raiden and King (2021) reinforce the discussion on project organisational performance as a critical factor in achieving social value. This article emphasises that organisational performance cannot be measured solely by traditional indicators (cost, quality, time), but rather through the organisation’s ability to learn, adapt, and collaborate to create social value. Organisational learning enables contractors, clients, and others to internalise social value into their strategies, policies, and work culture. Similarly, Felício et al. (2013) demonstrated that transformational leadership and social entrepreneurship are essential drivers linking social value to organisational performance, fostering innovation and responsiveness to societal needs. This suggests that project organisations achieve stronger performance when they combine efficiency with leadership, innovation, and learning capacity that enable the systematic creation of social value.

Design is the last influencing factor to achieve the project’s social value. The design has a significant influence on the project’s social value achievement because it directly impacts how a project serves and benefits the community. The project will satisfy the demands and preferences of the end-users if it is designed with them in mind. Because the initiative offers solutions that are pertinent to and beneficial to the community, this strategy increases user happiness and utility. Community acceptance of projects is higher when they honour and reflect local aesthetics and culture (Brooks et al., 2012). The social value of the project is increased by the citizens’ sense of identity and pride, which is fostered by this cultural alignment. As stated by Barton et al. (2021) that projects designed with accessibility in mind tend to deliver higher social value because they serve the needs of a wider audience. Design quality influences social value through user-centricity (safety, inclusivity, accessibility), placemaking (cultural resonance, aesthetics), and whole life performance (durability, adaptability, lifecycle benefits). In practice, design reviews should adopt social value as gatekeeping elements, ensuring that road projects integrate safety audits, inclusivity features, and context-sensitive elements from the early planning stages.

The conceptual model supports the broader agenda of smart and sustainable cities by integrating social, institutional and design dimensions that align with the United Nations Sustainable Development Goals, particularly SDG 9 (industry, innovation and infrastructure) and SDG 11 (Sustainable cities and communities). This linkage highlights the model’s relevance for advancing holistic sustainability in infrastructure planning and management. By translating abstract social value principles into a structured set of factors and indicators, the model provides a practical reference for integrating social considerations into road infrastructure decision-making and governance.

This study has several limitations that should be acknowledged. First, the proposed model is derived solely from a synthesis of prior literature and has not yet been empirically validated. Second, the scope is limited to road infrastructure projects, which may restrict the generalizability of the findings to other types of infrastructure. Third, the reviewed studies are geographically uneven, with a concentration in specific region, which may introduce contextual bias and limit the applicability of the model across different socio-institutional settings.

Future research should address these limitations by empirically validating the model through expert evaluations and stakeholder surveys. Statistical techniques such as multiple regression or structural equation modelling could be applied to test the hypothesis relationships across diverse project contexts. Beyond validation, advanced approaches such as Adaptive Neuro-Fuzzy Inference System (ANFIS) may be employed to build predictive models of project social value, enabling scenario analysis and decision support tools for policy makers and practitioners.

7 Conclusion

Project social value is the result of a project, as well as the long-term benefits and impacts expected from the project for stakeholders and the broader community. To optimise the achievement of the project’s social value, it is necessary to identify factors that influence the social value of a construction project. Five primary factors impacting the results of the literature study were identified, namely community engagement, government role, project sustainability practices, project organisational performance, and design. These five factors depend on 38 indicators that are divided into community engagement, which consists of eight indicators; government role, which consists of five indicators; project sustainability practices, which consists of nine indicators; project organisational performance, which consists of seven indicators; and design, which consists of eleven indicators. Together, these factors provide a structured framework for understanding how social value can be systematically embedded in infrastructure delivery.

Theoretically, the model advances social value research by integrating stakeholder and sustainability perspectives into a structured framework tailored to infrastructure projects. Practically, it provides a diagnostic tool for policymakers and practitioners to embed social value considerations into project design, procurement, and delivery processes.

As the model is based solely on literature synthesis, it has not been empirically validated. Future research should operationalise the identified factors into measurable constructs, test them across diverse project contexts, and explore predictive approaches such as ANFIS to simulate policy and project scenarios.
